Foreign direct investment (FDI) enterprises in Vietnam operate under a dual regulatory regime. While domestic firms hold only an Enterprise Registration Certificate (ERC), foreign-invested entities hold both an Investment Registration Certificate (IRC) under the Law on Investment 61/2020/QH14 and an ERC under the Law on Enterprises 59/2020/QH14.
When commercial operations evolve, multinational corporate groups frequently inject capital, relocate offices, replace executive officers, or adjust business lines. Navigating these modifications requires following strict inter-agency procedures. Failing to synchronize certificates or filing out of sequence freezes capital accounts, incurs administrative fines, and jeopardizes tax incentives.
1. Statutory Scope of IRC, ERC, and Joint Corporate Amendments
Foreign investors must categorize proposed corporate adjustments into three distinct procedural tracks to determine required filings, agency jurisdictions, and realistic operational timelines.
| Amendment Category | Governing Authority | Statutory Review Period | Key Examples |
|---|---|---|---|
| Dual Amendment (IRC + ERC) | Department of Finance / Industrial Zone Authority, then Business Registration Office | 10 to 35 working days (IRC) + 03 working days (ERC) | Capital adjustments, business line expansions, company name changes, headquarters relocation |
| IRC-Only Amendment | Department of Finance (incorporating former DPI) or IZA | 03 to 10 working days (Up to 35 if policy approval applies) | Project implementation schedule, machinery specifications, land area adjustments |
| ERC-Only Amendment | Business Registration Office (BRO) under provincial Department of Finance | 03 working days (Filing required within 10 days of change) | Legal Representative replacement, internal governance restructuring, minor VSIC detailing |
The division between certificates reflects Vietnamese administrative law. The IRC represents state authorization for foreign capital deployment into a defined project under Decree 31/2021/ND-CP (amended by Decree 239/2025/ND-CP). The ERC establishes corporate legal personality and civil liability under Decree 01/2021/ND-CP.
When corporate modifications touch overlapping fields, such as expanding business scope or altering investment capital, the entity must first obtain approval from the investment licensing authority before amending its enterprise register.
2. Mandatory Procedural Sequence: IRC First or ERC First?
A frequent procedural mistake among foreign managers is attempting to file corporate modifications simultaneously at the Business Registration Office and the Investment Registration Division.
The Substantive Priority Rule
Under Article 41 of the Law on Investment 2020 and Article 47 of Decree 31/2021/ND-CP, corporate changes affecting IRC parameters require amending the IRC prior to updating the ERC. The Business Registration Office requires the amended IRC as a mandatory statutory exhibit when processing charter capital, address, or business scope changes.
Attempting to reverse this sequence results in immediate rejection of the ERC application. The Business Registration Office cannot record an increase in foreign equity or an expansion into new economic sectors without verified proof that the Investment Registration Authority has vetted the capital source and approved the project scope under Vietnam’s market access reservations.
Sequential Workflow
The end-to-end adjustment follows a structured three-phase sequence:
- Phase 1 (IRC Adjustment at Department of Finance or Industrial Zone Authority): Submit the project adjustment dossier online via the National Foreign Investment Information System (fdi.gov.vn) and physically to the Investment Registration Division. Statutory review takes 10 working days for standard project amendments, or 03 working days if changing only investor or project names.
- Phase 2 (ERC Amendment at Business Registration Office): Within 10 calendar days of corporate approval, the enterprise submits an amendment application to the Business Registration Office via the National Business Registration Portal (dangkykinhdoanh.gov.vn), attaching the newly issued amended IRC. Statutory processing takes 03 working days.
- Phase 3 (Downstream Regulatory Synchronization): Update tax records, bank signatories on direct investment capital accounts (DICA), customs profiles, and electronic invoice templates within 10 to 30 days.
3. Procedures for Increasing or Decreasing Investment and Charter Capital
Capital adjustments are among the most heavily scrutinized corporate amendments in Vietnam. Licensing authorities evaluate whether the capital change reflects genuine commercial capacity, complies with project commitments, and preserves creditor protections.
Capital Increase Protocol

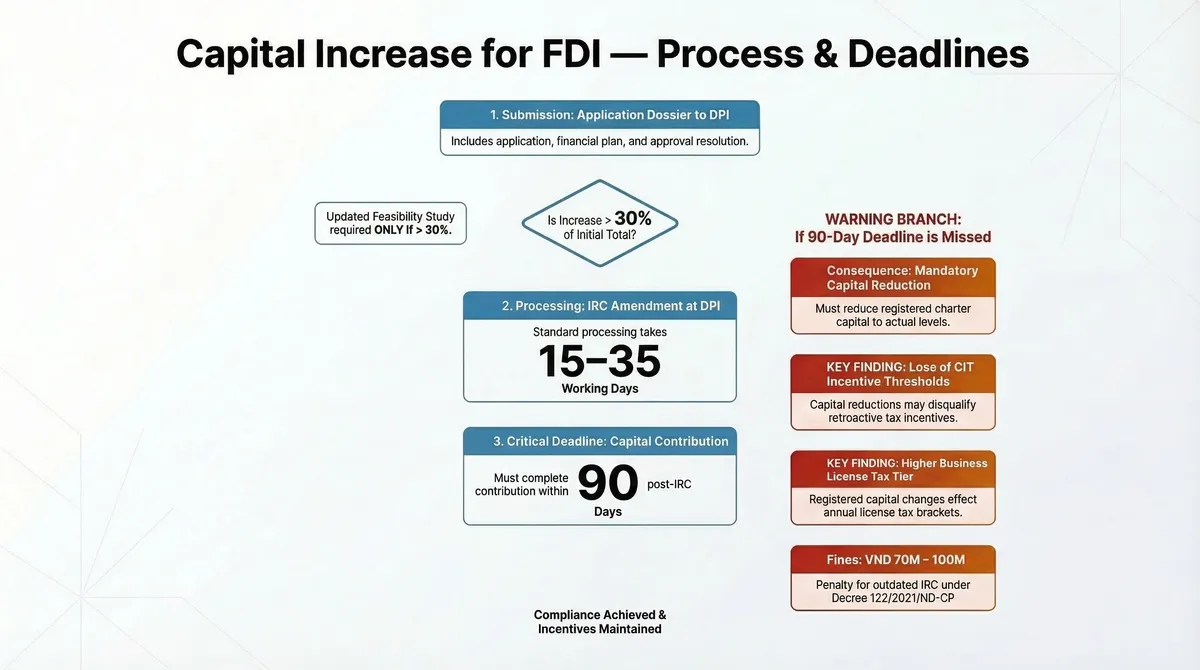

An FDI enterprise can increase capital through cash injections or capitalization of retained earnings.
Key statutory requirements during a capital increase include:
- Financial Capacity Proof: Foreign investors must provide parent company audited financial statements or certified bank balance confirmations demonstrating immediate liquidity matching the capital increase.
- Historical Capital Verification: The licensing authority examines whether initial charter capital was fully disbursed within the mandatory 90-day window under Article 47 of the Law on Enterprises 2020. Unresolved capital shortfalls trigger administrative penalties before capital expansion applications are processed.
- DICA Routing Requirement: Under Circular 06/2019/TT-NHNN, all cash capital increases must flow exclusively through the enterprise’s Direct Investment Capital Account (DICA) opened at an authorized commercial bank in Vietnam.
Capital Decrease Protocol
Decreasing capital is subject to rigorous regulatory hurdles designed to protect domestic creditors and state tax revenue. Under Article 68 of the Law on Enterprises 2020, a limited liability company (LLC) can only reduce charter capital if it has operated continuously for at least two consecutive years from corporate registration and guarantees full settlement of all mature debts post-reduction.
The application dossier submitted to the Department of Finance and the Business Registration Office must include audited financial statements demonstrating that net asset value exceeds revised charter capital, a written solvency commitment from the Legal Representative, and tax clearance confirmation from the supervisory tax authority verifying zero outstanding tax debts.
4. Adjusting Project Objectives and Adding Conditional Business Lines

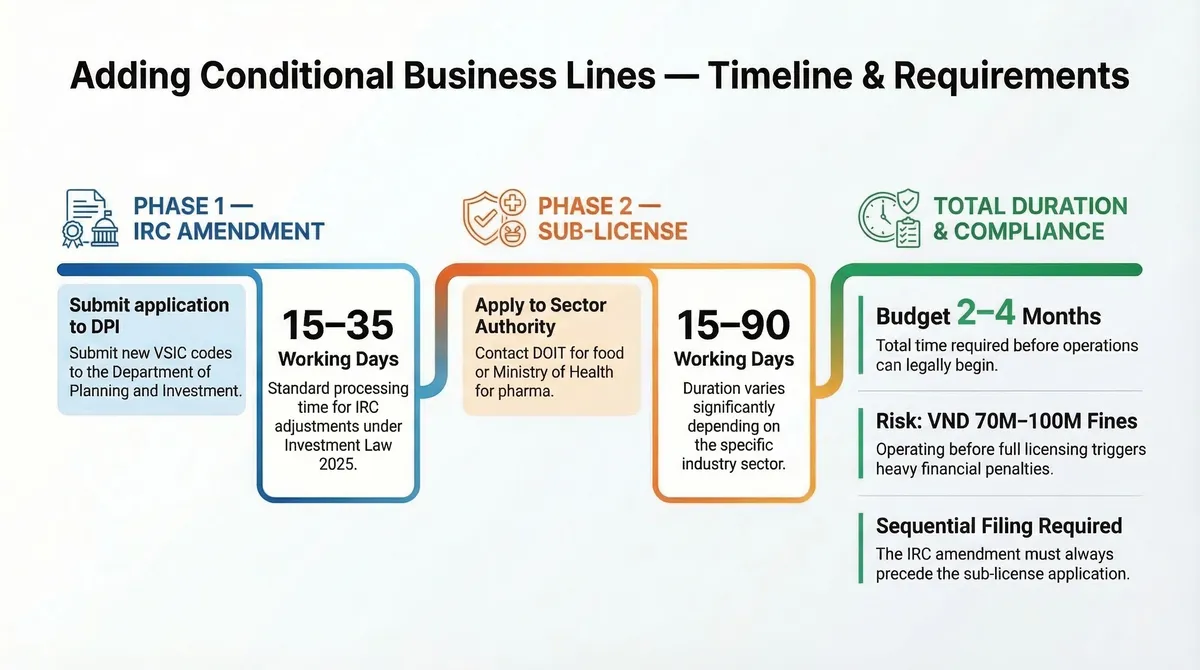

Expanding into new commercial sectors requires meticulous alignment between Vietnam Standard Industrial Classification (VSIC) codes and foreign ownership limits established in Vietnam’s WTO Commitments and domestic investment schedules.
| Business Sector | Licensing Pathway | Regulatory Framework & Conditions |
|---|---|---|
| Standard IT & Software Services (VSIC 6201, 6202) | Standard IRC + ERC amendment (10 days + 3 days) | 100% foreign ownership permitted; no operational sub-license required |
| Wholesale Trading (VSIC 4659, 4690) | Standard IRC + ERC amendment (10 days + 3 days) | Unrestricted for standard goods; sub-licenses apply to lubricants, rice, and pharmaceuticals |
| Retail Distribution (VSIC 4711, 4719) | IRC amendment -> ERC amendment -> DOIT Trading License | Retail License required under Decree 09/2018/ND-CP; Economic Needs Test (ENT) for 2nd+ outlets |
| Vocational & Language Education (VSIC 8559) | IRC amendment -> ERC amendment -> DOLISA / MOET License | Education Operation License required under Decree 86/2018/ND-CP and Decree 46/2017/ND-CP |
Foreign investors must note that an amended IRC merely recognizes legal capacity to prepare for conditional investment. The enterprise cannot execute commercial contracts, invoice customers, or collect revenue in conditional sectors until it obtains the formal sector sub-license from the competent line ministry.
5. Changing the Legal Representative and Registered Office Address
Modifications to corporate leadership and registered corporate headquarters represent routine but high-risk procedural events for foreign-invested operating subsidiaries.
Legal Representative Changes

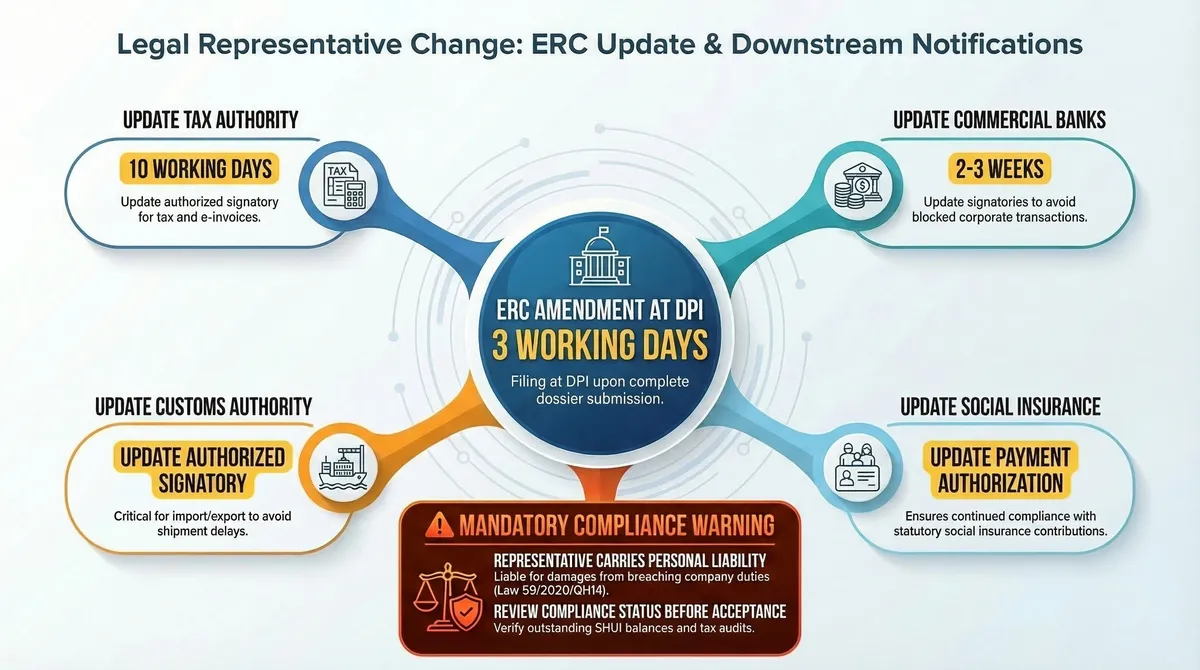

Unlike domestic companies, an FDI enterprise must determine whether its Legal Representative is explicitly identified in the investment project documents:
- Standard Scenario (ERC Amendment Only): Under Article 12 of the Law on Enterprises 2020, replacing the Legal Representative requires only an ERC amendment filed with the Business Registration Office within 10 days. The statutory processing timeline is 03 working days.
- Exception Scenario (Joint IRC and ERC Amendment): If the individual being replaced was formally designated as the project representative on the IRC, the enterprise must file an IRC adjustment concurrently or sequentially.
- Work Permit Compliance: If the incoming Legal Representative is a foreign national, the enterprise must comply with work permit rules under Decree 219/2025/ND-CP, or obtain an exemption certificate if capital contribution exceeds VND 3,000,000,000.
Headquarters Relocation Protocols
Relocating an FDI entity involves differing jurisdictional requirements depending on municipal boundaries:
- Intra-District Relocation: Requires updating the IRC at the Department of Finance or Industrial Zone Authority (10 working days) and updating the ERC at the Business Registration Office (03 working days). Tax registration transfers execute automatically.
- Inter-District or Inter-Provincial Relocation: Triggers a mandatory tax finalization review at the departing tax authority under Circular 105/2020/TT-BTC. The departing tax office must issue Form 09-MST confirming zero outstanding liabilities before the new provincial authorities accept the relocation dossier.
6. Post-Amendment Compliance and Bank-Tax Reconciliation Protocols
Securing an amended IRC and ERC is only the midway point of corporate adjustments. Downstream compliance failures frequently disrupt day-to-day operations weeks or months after certificate issuance.
| Compliance Requirement | Statutory Deadline | Governing Authority / Counterparty | Operational Risk if Omitted |
|---|---|---|---|
| National Business Portal Publication | Within 30 days of ERC issuance | National Business Registration Portal | VND 10M-15M fine under Decree 122/2021/ND-CP |
| Tax Registration Update | Within 10 working days of ERC | Supervisory Tax Department | Tax filing mismatches and blocked e-invoice credentials |
| Bank & DICA Signatory Update | Immediate upon ERC issuance | Commercial Bank holding DICA | Inability to disburse capital or execute foreign payments |
| E-Invoice Template Recalibration | Prior to issuing next e-invoice | Tax Authority via eTax portal | Disallowance of customer VAT deductions under Decree 123 |
| National FDI Portal Reporting | Next quarterly reporting cycle | Investment Authority via fdi.gov.vn | Administrative penalties and freeze on future amendments |
Under Circular 06/2019/TT-NHNN, all capital contributions, foreign shareholder loans, and dividend repatriations must flow exclusively through the DICA account. Commercial banks will reject incoming capital remittances until presented with both the amended IRC and amended ERC.
7. Administrative Penalty Framework and Project Freeze Risks
Operating an enterprise with discrepancies between commercial reality and state-issued certificates triggers severe administrative sanctions and administrative freezes.
| Violation Category | Statutory Decree Citation | Fine Range (Corporate) | Mandatory Remedial Action |
|---|---|---|---|
| Failure to Amend IRC (Operating outside approved project parameters) | Decree 122/2021/ND-CP, Article 17, Clause 2 | VND 70,000,000 to VND 100,000,000 | Compelled execution of IRC project amendment procedures |
| Late ERC Amendment Notification (11 to 30 days past statutory 10-day window) | Decree 122/2021/ND-CP, Article 44, Clause 2 | VND 3,000,000 to VND 5,000,000 | Compelled submission of valid enterprise registration dossier |
| Late ERC Amendment Notification (31 to 90 days past statutory deadline) | Decree 122/2021/ND-CP, Article 44, Clause 3 | VND 5,000,000 to VND 10,000,000 | Compelled submission of valid enterprise registration dossier |
| Late ERC Amendment Notification (91 days or more past statutory deadline) | Decree 122/2021/ND-CP, Article 44, Clause 4 | VND 10,000,000 to VND 20,000,000 | Compelled submission of valid enterprise registration dossier |
| Total Failure to Register ERC Changes (Operating unnotified corporate changes) | Decree 122/2021/ND-CP, Article 44, Clause 5 | VND 20,000,000 to VND 30,000,000 | Compelled registration and rectification of corporate data |
| Failure to Update National FDI Portal (Quarterly reporting and project monitoring) | Decree 122/2021/ND-CP, Article 15, Clause 1 | VND 20,000,000 to VND 30,000,000 | Compelled electronic reporting on fdi.gov.vn portal |
Beyond direct monetary fines, operating with unamended certificates creates administrative paralysis. Licensing officers cross-reference project records on the National Investment Information System before approving work permits, visa sponsorships, or subsequent project expansions.
Indochina Link Vietnam provides specialized corporate secretarial, licensing, and investment advisory services across Vietnam. Our legal team prepares dual-licensing dossiers, liaises with the Department of Finance and industrial zone boards, and manages downstream banking and tax reconciliations. Contact our corporate licensing team to structure your corporate amendments.
